The process

Twenty-one stages, and what each one is for.

Redrawn from the company's own printed process chart. Stages 1 to 13 are the micronizer plant; 14 to 21 are the optional coating line that follows it.

Micronizer plant process flow: 21 numbered stages from crusher to finished coated product

The chart is the company's own; only the rendering is new. Scroll it sideways on a narrow screen, or read the stage list below — it carries the same content.

Stage by stage

What happens, and in what order.

Size reduction

Stages 1–7
  1. 1

    CrusherSize reduction

    Reduces run-of-mine rock to a feed the mill can take. Jaw crusher, 16 in × 9 in.

  2. 2

    Elevator-1Material handling

    Bucket elevator lifts crushed material to the first storage hopper.

  3. 3

    Hopper-1Material handling

    Storage hopper buffers the crusher from the rest of the line.

  4. 4

    DescendicatorSize reduction

    Beater-type disintegrator. Required to bring 30/80 mesh grains to mill feed size.

  5. 5

    Elevator-2Material handling

    Lifts disintegrated material to the mill feed hopper.

  6. 6

    Hopper-2Material handling

    10 tonne mill feed hopper, 2000 × 2000 mm, with a screw feeder underneath.

  7. 7

    Ball MillSize reduction

    14 ft × 6 ft air-swept ball mill. The grinding stage — everything before it prepares the feed, everything after it separates the product.

Classification

Stages 8–10
  1. 8

    ClassifierSeparation

    1000 mm high-efficiency dynamic classifier. Cage speed sets the cut point, and so the fineness.

  2. 9

    Coarse returnSeparation

    Oversize from the classifier goes straight back to the mill inlet. This is what makes it a closed circuit.

  3. 10

    Fine materialSeparation

    Product-size particles travel on in the air stream to the collection stage.

Collection

Stages 11–13
  1. 11

    RPJ Bag FilterCollection

    Reverse pulse jet filter, cleaned on line, collects the product out of the air.

  2. 12

    Rotary AirlockCollection

    300 mm valve discharges the collected powder while holding the pressure difference.

  3. 13

    BlowerCollection

    400 CFM centrifugal blower draws the air through the whole circuit.

Coating line — optional

Stages 14–21
  1. 14

    Elevator-3Material handling

    Coating line begins. Lifts finished powder to the coating feed hopper.

  2. 15

    Hopper-3Material handling

    Feed hopper for the coating line.

  3. 16

    Screw Conveyor-1Material handling

    6 in screw feeder meters powder into the mixer.

  4. 17

    MixerSurface coating

    Powder and molten stearic acid are brought together.

  5. 18

    Screw Conveyor-2Material handling

    Carries the treated powder on to the pulveriser.

  6. 19

    PulveriserSize reduction

    Breaks any agglomerates formed during coating.

  7. 20

    Elevator-4Material handling

    Lifts coated product to final storage.

  8. 21

    Hopper-4Material handling

    Finished coated product, ready for packing.

As the works draws it

The same line, from our own CAD assembly.

Each machine named the way the works names it. The chart above is the process; this is the arrangement it is built in.

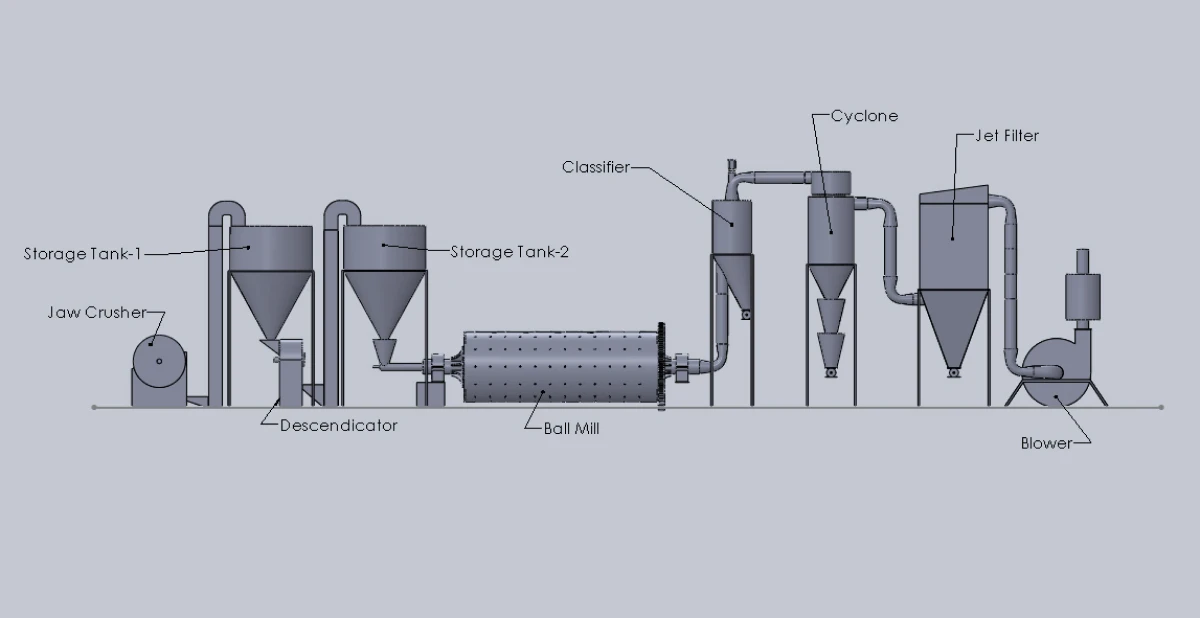

Labelled CAD schematic of a micronizer plant: jaw crusher, storage tank 1, descendicator, storage tank 2, ball mill, classifier, cyclone, jet filter and blower

Jaw crusher · storage tank 1 · descendicator · storage tank 2 · ball mill · classifier · cyclone · jet filter · blower.

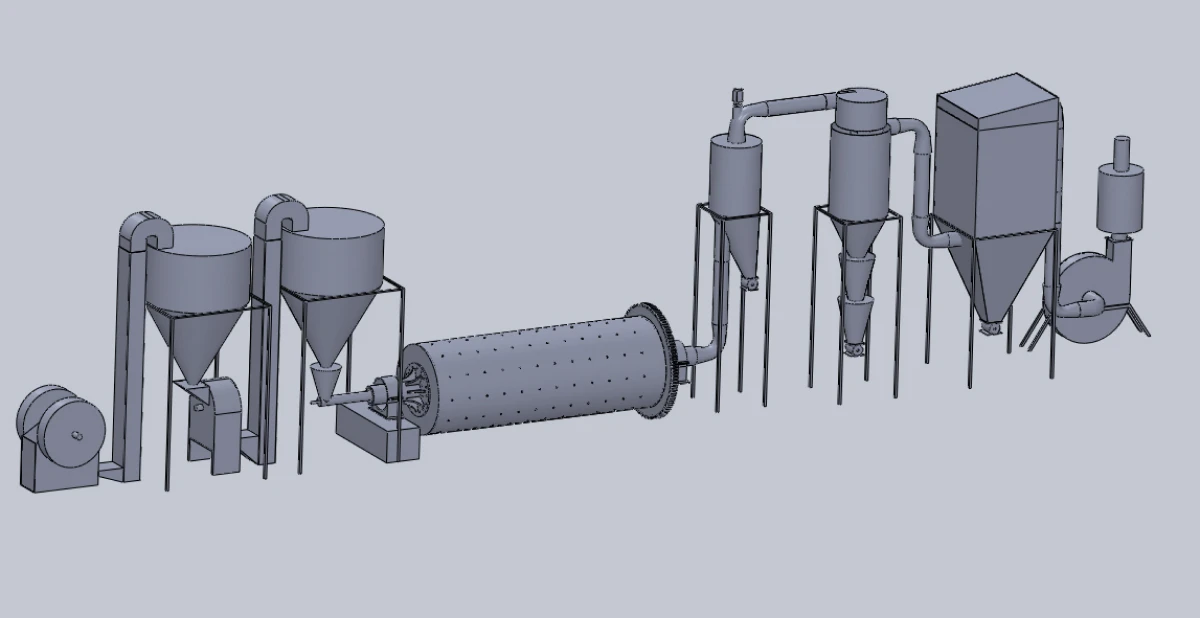

Three-dimensional CAD render of the complete micronizer plant assembly

The same assembly rendered from the works' three-dimensional model.

Seen as a machine

The same twenty-one stages, built.

Every stage in the chart above is a real machine bolted to a real floor. This is the line as it stands, drawn from the company's CAD assembly.

The complete micronizer plant line, drawn in elevation with all ten machines connected

What the site has to provide

Before the erection team arrives.

Space and civil work

A bay of 40 ft long × 20 ft wide × 30 ft high per micronizer plant. The mill foundation is poured by the customer to a dimensioned drawing AEW supplies; the foundation frame is collected from the AEW workshop.

During erection

Roughly seven days on site. The customer provides a 12–14 tonne crane for three of them, plus oxygen, an LPG cylinder and a welding machine, and food and accommodation for the team. Panel, cables and accessories are bought separately.

Want the process sized to your tonnage?

Send us a target fineness and a required output and we will come back with a plant configuration and a scope of supply.
